Coral Crest Condominium · Miami-Dade

From findings
to finished work.

Electrical corrections across four buildings, with the photographs and inspection records to tell the story.

Final exterior view at Coral Crest: labeled Main 1 and Main 2 disconnects and closed wireway covers
15270 SW 80th Street · After the limited corrective work
Property
Four condominium buildings
Work completed
October 18, 2026
Scope
Targeted electrical corrections
Documentation
Inspection + before & after photos
A clear path from inspection to action

The finding is
only the beginning.

For an association or property manager, a report needs to lead somewhere. This project brought the inspection findings into a defined repair scope—and documented the work.

At Coral Crest, Waveform addressed electrical connections, grounding, conductor arrangement, covers, anchoring, and equipment identification within the agreed scope for four buildings along SW 80th Street.

All agreed limited-scope corrections completed.Completion confirmed by Waveform for the October 18, 2026 work visit.
The difference is in the details

Before. After.
See it for yourself.

15250 SW 80th Street

A closer look inside Main 1.

The agreed correction included compatible multiport lugs, adapters, conductor repositioning, and identification. The open-main photographs document the equipment before the work and during the corrective visit.

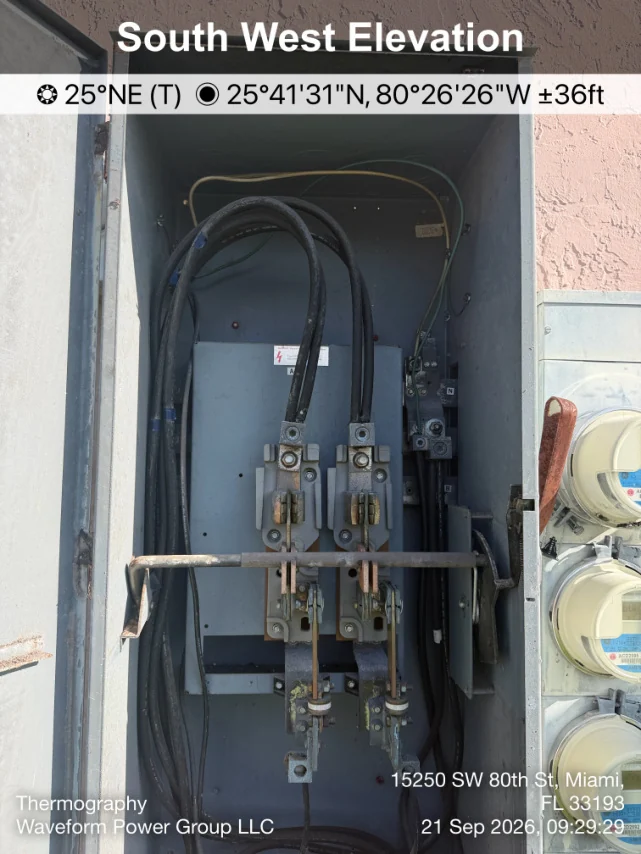

BeforeSeptember 21, 2026
Main 1 interior at 15250 before corrections, September 21, 2026
Open full photograph

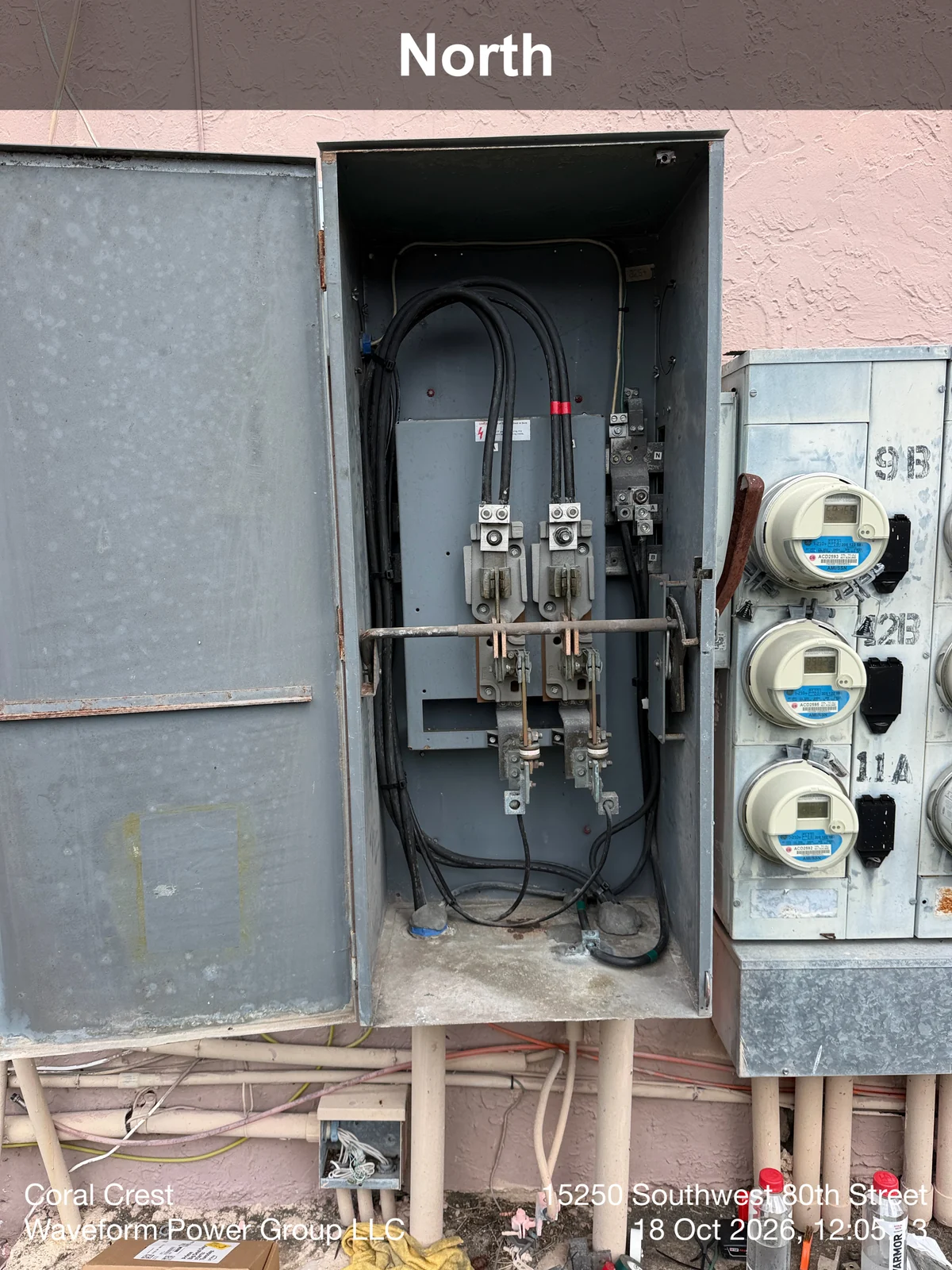

After correction · work-stage viewOctober 18, 2026
Main 1 interior at 15250 during the October 18 corrective-work visit
Open full photograph

The October image shows the enclosure open for work documentation; it is not the final closed or energized condition.

Start with the evidence

Make the
invisible visible.

Thermography adds measured context to an electrical inspection. At 15270, Main 2, the original report recorded an apparent temperature difference between the marked measurement regions.

11.6°C

Apparent difference
39.8°C − 28.2°C

BASELINE INSPECTION · SEPTEMBER 21, 2026

View the Thermal Report Excerpt

PDF · 2 pages · 3.9 MB · Opens in a new tab

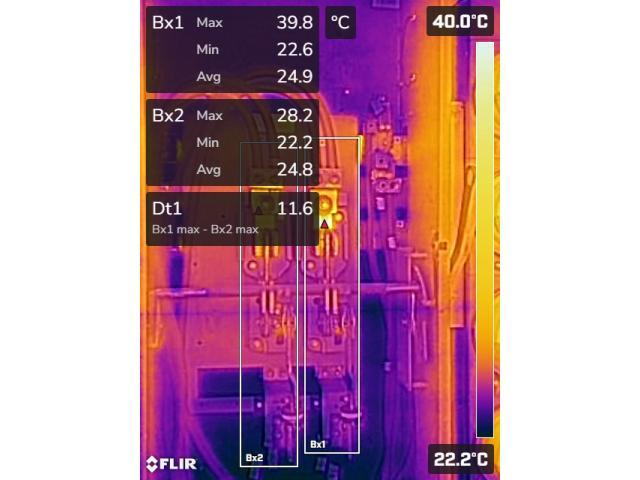

Original September 21 thermogram of 15270 Main 2, showing marked measurement regions and a temperature scale
Original report, page 12. This is the pre-repair inspection record; it does not represent a post-repair thermal retest.
One project. Building-specific work.

A defined scope.
Attention to each building.

Every building had its own correction list. The completion record ties those items to the equipment and the work visit.

15250SW 80TH STREET

Connections & conductor arrangement

Compatible multiport lugs, adapters, conductor repositioning, and main disconnect identification.

Completed
15260SW 80TH STREET

Grounding & identification

The agreed adapter and grounding corrections, grounding electrode work, connection checks, and main disconnect labels.

Completed
15270SW 80TH STREET

Service details & receptacle protection

Adapter corrections, termination checks, a hinged receptacle cover, and identification for both mains.

Completed
15280SW 80TH STREET

Covers, anchoring & routing

Adapter and conductor-routing corrections, enclosure anchoring, four breaker covers, and main disconnect labels.

Completed

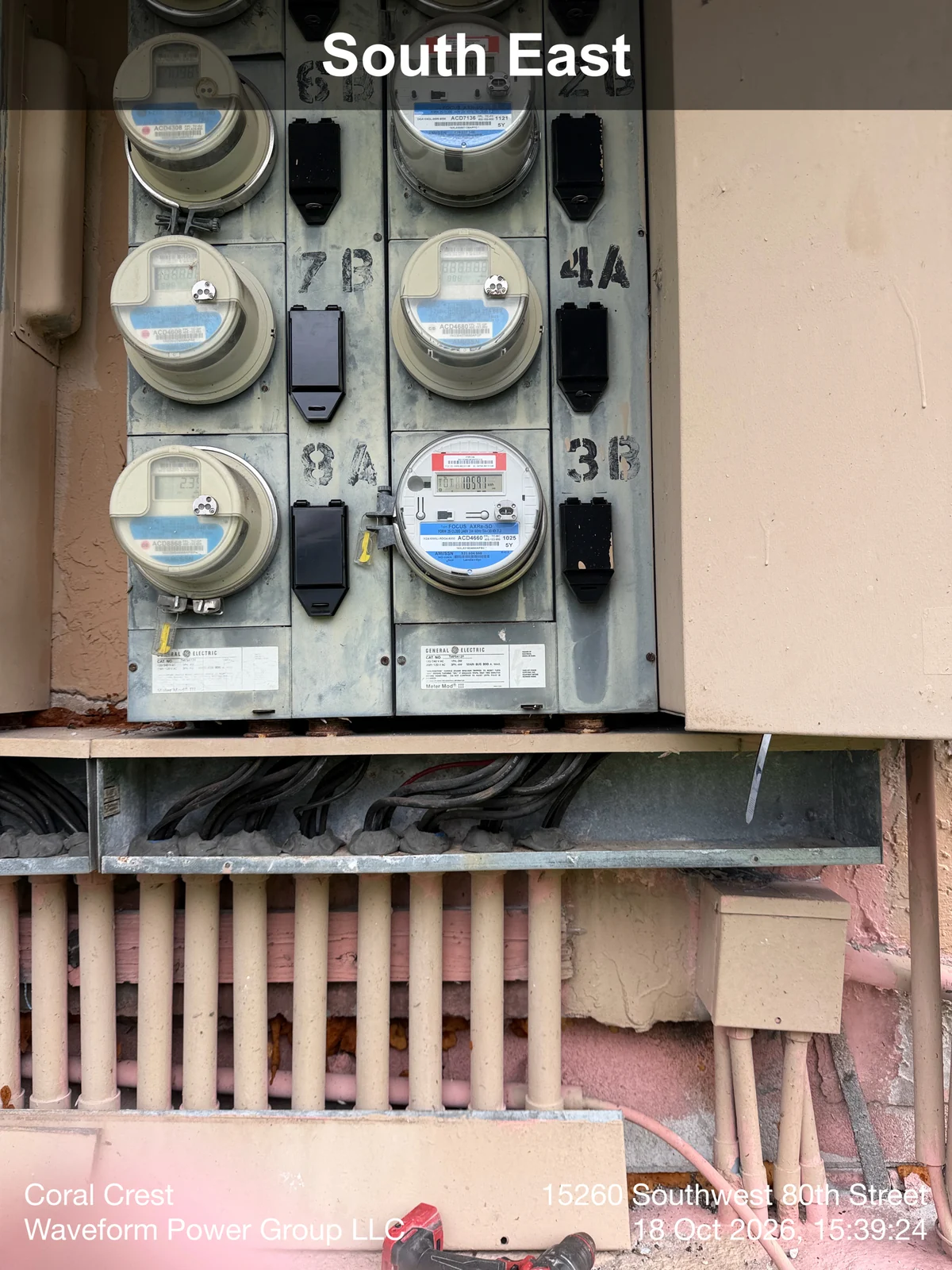

The breaker-cover photographs show building 15280, identified by matching equipment; their camera address stamp of 15260 is incorrect. Open-main and wireway views document work stages.

About the photographs and project records

Before photographs come from the corrective-work proposal. October 18 photographs document the corrective visit; open cabinets and wireways show work stages. Some camera location stamps were incorrect while moving between buildings. Building assignments here follow matched equipment, as confirmed by the contractor; original image stamps remain visible.

The thermal excerpt contains an explanatory cover and the unchanged original September 21 report page. Thermal readings describe the conditions recorded at that inspection. The completion statement applies to the agreed limited corrective scope. General corrosion, paint and finish restoration, full equipment replacement, and final building recertification approval are outside this completion statement.

What you can expect from Waveform

Engineering insight.
A practical plan. A documented result.

01

Understand the findings

Discuss what the inspection identifies and the electrical work needed for your property.

02

Define the next step

Agree on the repair scope, access, coordination, and deliverables before the work begins.

03

Keep a useful record

Connect completed work to photographs and project documentation you can refer back to.

Florida Professional
EngineerPE 97833
Certified Electrical
ContractorEC13013232
Level II Infrared
Thermographer
Let’s work together

Have findings that need a plan?

Send your inspection report, property address, and target date. We’ll help define the electrical correction scope for your building.
